22 August 2025
Does that tiled shower require a Building Consent? This article highlights some new information that you may find useful if looking at buying or selling a property with bathrooms that have been renovated.
Bathroom renovations, tiled showers and whether or not they require a Building Consent has long been a confusing and contentious area. Disagreements between parties and their professionals about whether work needed a Building Consent or not can definitely throw a spanner in the works with property transactions.
Often, information published by official sources can be incomplete and unclear, resulting in a lack of consensus around interpretation - by consumers and the builders that carry out the work for them. As well as the various professionals that work in the property space (building inspectors, solicitors, agents, mortgage and insurance advisors).
Here are a few of the points of view I've heard over my time selling real estate. Do some of them sound familiar?
Here's what Auckland Council's website says.
And should you request further clarification, Auckland Council will often direct you to the Wet Area Showers Require a Building Consent page by MBIE. This page explains what a Wet Area Shower is.
You'll notice that both Auckland Council and MBIE mention 'waterproof membranes' as being critical building work in their reasoning for wet area showers requiring a building consent.
So, if it needs waterproofing, it must be a 'wet area shower' - and require a Building Consent - right?
Not quite.
MBIE released this determination late last year which confirmed that Clause 12 of Schedule 1 of the Building Act 2004 (work that does not require a building consent) does not exclude waterproof membranes. Thus it includes them.

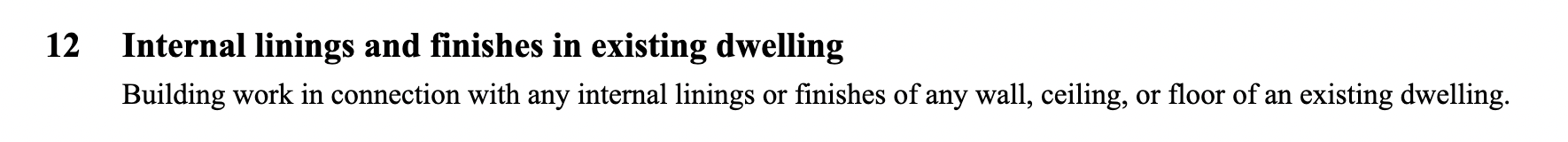

For your easy reference, here is what Clause 12 says.
Interestingly, the party that applied for the determination, referred MBIE to the advice stated on their own website, but the lead determination specialist responded by saying that "the guidance issued on their (MBIE) website does not supercede the (Building) Act or its regulations."
This week I emailed the Building Desk at Auckland Council to ask for comment on this determination as it appears to contradict information on their website stating that you WILL need a building consent for a tiled shower - rather than that you MAY need one.
I said..
"Re: the MBIE guidance you've linked to in your response, Determination 2024/054 specifically addresses that guidance as not superseding the Act or its regulations (4.18), determining that removal of existing linings and installation of new ones, including wet area membranes, falls within the scope of Clause 12 of Schedule 1 (4.17). Additionally, while the determination above relates to tiled walls, Clause 12 of Schedule 1 specifically includes the floor.
..would it be safe to conclude building consent is only required for a tiled shower if the specifics of the work being carried out is not covered by an exemption in Schedule 1 (including Clause 12 as it relates to installing waterproof membranes)?"
They responded..
"Please read MBIE’s definition for ‘wet area shower’ (as not all showers are included in this definition, even though in reality all showers are wet areas).
...a shower becomes a ‘wet area shower’ if the existing floor structure (joists etc.) needs to be changed to achieve a level access. If only the linings and finishes (which includes membranes as they are sandwiched between the lining and finish) are changing, then you have correctly interpreted that the building work will fall under Schedule 1 and not require building consent. My understanding is that this is what the determination is clarifying for the industry."
I am stoked to have solid information to refer my sellers and buyers to on this topic. Here is what I suggest.
I hope this is helpful!
